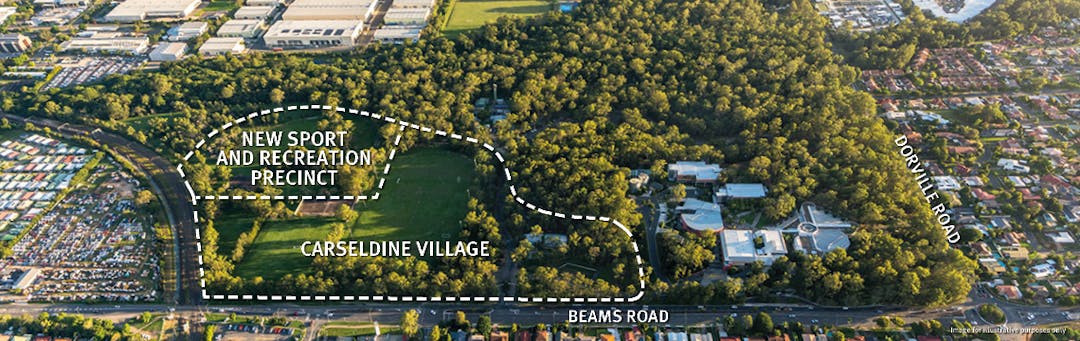

Carseldine Village
FOR THE LATEST INFORMATION go to carseldinevillage.com.au
Carseldine Village, a new residential community on Brisbane’s northside, is being developed by Economic Development Queensland (EDQ), a government agency that combines property development with specialist planning functions, on the site of the former QUT campus at Carseldine.
Carseldine Village will be an exemplar of sustainable development – the first residential development in Queensland to commit to delivering 100% net-zero energy emission homes with energy-saving features.
On completion, the new village will consist of mixed-use, diverse, and affordable residential, small commercial and retail, along with bushland and recreational open space areas.
At CarseldineContinue reading
FOR THE LATEST INFORMATION go to carseldinevillage.com.au
Carseldine Village, a new residential community on Brisbane’s northside, is being developed by Economic Development Queensland (EDQ), a government agency that combines property development with specialist planning functions, on the site of the former QUT campus at Carseldine.
Carseldine Village will be an exemplar of sustainable development – the first residential development in Queensland to commit to delivering 100% net-zero energy emission homes with energy-saving features.
On completion, the new village will consist of mixed-use, diverse, and affordable residential, small commercial and retail, along with bushland and recreational open space areas.
At Carseldine Village, 75 per cent of the bushland is being retained and there are more than 18 hectares of green and open space. The Cabbage Tree Creek bushland, called The Sanctuary, is going through rehabilitation works with the planting of 20,000 new plants, trees and shrubs, and the installation of over 200 nesting boxes.
The masterplan for Carseldine Village is proposed to be developed in 5 stages. The current approved masterplan provides for a maximum of 606 dwellings. In one of the future stages, a village retail heart will potentially comprise a convenience supermarket, specialty retail and dining.
The Government Office Precinct, C&K Child Care Centre, and Carseldine Markets remain.
Construction update
Stage 1 construction includes:
- Stage 1 terrace homes - complete.
- Stage 1 civil and electrical works - complete.
- A new entry road into Carseldine Village, called Plaza Place - complete
- The three intersection upgrades to Beams and Dorville Roads - complete
- Rockpool Residential Aged Care - complete.
Stage 2 construction includes:
- Stage 2 terrace homes - under construction.
- Stage 2 civil and electrical works - complete.
Stage 3A construction includes:
- Stage 3A terrace homes - under construction.
- Stage 3A civil and electrical works - complete.
Stage 4A construction includes:
- Stage 4A civil and electrical works - complete.
Stage 4B construction includes:
- Stage 4B and 4C civil and electrical works - complete.
Stage V construction includes:
- Stage V scope of works includes service relocations, demolition of existing C&K building, vegetation clearning, earthworks, underground service installation, retaining wall construction, roadworks, and landscape works. Works are underway
Stage releases
Stage 1 which includes 53 terrace homes is sold out.
Stage 2 which includes 49 terrace homes is sold out.
Stage 3A which includes 15 terrace homes is sold out.
4A Release which includes 10 terrace homes is sold out.
4B Release which includes 13 terrace homes is sold out.
4C Release is now selling with one terrace house and land package remaining.
For enquiries or information, please email hello@carseldinevillage.com.au
The Green
The Green, a new $6.5 million sport and recreation precinct that stretches over four hectares and incorporates the latest technology opened on 11 January 2020.
The Green includes three soccer fields (of which two are dual-purpose soccer/rugby league); two volleyball courts; two dual-purpose tennis/netball courts; a half-court basketball court; an outdoor ping pong table; a turf cricket pitch and synthetic practice nets; an all-abilities playground; yoga lawn; exercise equipment; BBQs, shaded seating, public toilets, and sports change room facilities and more than 120 car parks.
Bookings for the sports facilities at The Green can be made via the Carseldine Village website.
Rockpool Residential Aged Care
Rockpool Residential Aged Care is now open.
A $43 million Residential Aged Care facility. This 6-level, 150-bed accommodation and care facility will offer aged care, respite care and specialist memory support care.
The Rock's Cafe, located on the ground floor of Rockpool Residential Aged Care is also open.
C&K Childcare
The brand-new C&K Childcare Centre next to Rockpool Residential Aged Care is now open.
This new intergenerational care collaboration is a pioneering step towards better social outcomes and innovating the social fabric within residential villages across Queensland.
This new Centre will create opportunities for meaningful social interactions, integrating new ideas to add to the quality of life and social development benefits for the community.
More information
For more information on Carseldine Village, please visit our website on:
View the Carseldine Village development applications below:
EDQ reference | Description |
Stage S – The Green sport and recreation precinct | |
Masterplan for Carseldine Village | |
Management lot subdivision | |
Cabbage Tree Creek pedestrian and cycle bridge | |
Stage 1 – Terrace lots and aged care/retirement lot | |
Stage 2 – Terrace lots |
-
Beams Road rail level crossing
Share Beams Road rail level crossing on Facebook Share Beams Road rail level crossing on Twitter Share Beams Road rail level crossing on Linkedin Email Beams Road rail level crossing linkDepartment of Transport and Main Roads (DTMR) has commenced works on the Beams Road rail level crossing project. The below links provide details of the works proposed in this area.
To find out further information on the above project, please contact DTMR on the details below:
- Email: metropolitanregion@tmr.qld.gov.au
- Phone: (07) 3066 4338
-
Community notice - Stage V works - Carseldine Village
Share Community notice - Stage V works - Carseldine Village on Facebook Share Community notice - Stage V works - Carseldine Village on Twitter Share Community notice - Stage V works - Carseldine Village on Linkedin Email Community notice - Stage V works - Carseldine Village linkStage V subdivision works have commenced.
For further details read the Community Notice
If you have any concerns please contact alex.bax@shadcivil.com.au or 0412 903 786
-
Community notice - Stage 4B civil works and catch drain works
Share Community notice - Stage 4B civil works and catch drain works on Facebook Share Community notice - Stage 4B civil works and catch drain works on Twitter Share Community notice - Stage 4B civil works and catch drain works on Linkedin Email Community notice - Stage 4B civil works and catch drain works linkStage 4B civil works and catch drain works have commenced.
For further details read the Community Notice
If you have any concerns please contact alex.bax@shadcivil.com.au or 0412 903 786
-
Community notice - Survey and investigation works - Beams Road
Share Community notice - Survey and investigation works - Beams Road on Facebook Share Community notice - Survey and investigation works - Beams Road on Twitter Share Community notice - Survey and investigation works - Beams Road on Linkedin Email Community notice - Survey and investigation works - Beams Road linkSurvey and investigation works will be carried out on Beams Road from Monday 21 November to Wednesday 23 November from 8pm-5am.
Works will be carried out at night to ensure the safety of motorists and workers, and to minimise traffic disruptions.
For further details please read the notice by Utility Location Services here
If you have any concerns please contact the team on 0455 660 474 (business hours) or 1300 001 857 (24 hours) or admin@utilitylocationservices.com.au.
-
Community notice: temporary road closure - Plaza Place - Friday 11th November
Share Community notice: temporary road closure - Plaza Place - Friday 11th November on Facebook Share Community notice: temporary road closure - Plaza Place - Friday 11th November on Twitter Share Community notice: temporary road closure - Plaza Place - Friday 11th November on Linkedin Email Community notice: temporary road closure - Plaza Place - Friday 11th November linkTemporary road closure of the end of Plaza Place, Carseldine, Friday 11th November. Traffic Control Innovations and Shadforth Civil will be working between the hours of 6.30am - 6pm.
NOTE: there will be no through road connection to Dorville Road.
For further details, please read the notice by Traffic Control Innovations here
If you have any concerns please contact rangi@tcinnovations.com.au or 0438 229 603
-
Community notice: Development Application lodged - Carseldine Village - Drainage swale and maintenance access track works including vegetation clearing, earthworks and landscape works
Share Community notice: Development Application lodged - Carseldine Village - Drainage swale and maintenance access track works including vegetation clearing, earthworks and landscape works on Facebook Share Community notice: Development Application lodged - Carseldine Village - Drainage swale and maintenance access track works including vegetation clearing, earthworks and landscape works on Twitter Share Community notice: Development Application lodged - Carseldine Village - Drainage swale and maintenance access track works including vegetation clearing, earthworks and landscape works on Linkedin Email Community notice: Development Application lodged - Carseldine Village - Drainage swale and maintenance access track works including vegetation clearing, earthworks and landscape works linkWe wish to notify you that a Development Application for Operational Work was properly made on 21 September 2022. This new Development Application proposes the construction of a new drainage swale and maintenance access track. These works include vegetation clearing, earthworks and landscape works.
Details of the Development Application can be found here: DEV2022/1329
-
Community notice: Traffic diversion – Promenade Street access to The Green
Share Community notice: Traffic diversion – Promenade Street access to The Green on Facebook Share Community notice: Traffic diversion – Promenade Street access to The Green on Twitter Share Community notice: Traffic diversion – Promenade Street access to The Green on Linkedin Email Community notice: Traffic diversion – Promenade Street access to The Green linkBMD advise that due to the Carseldine Village development and associated road works, a section of Promenade Street will be temporarily closed from 28 September 2022 till 16 October 2022, to allow for the planned roadworks to take place.
For further details, please read BMD’s latest construction update.
-
Community notice: Development Application lodged - Carseldine Village Stage V (future Village Heart precinct)
Share Community notice: Development Application lodged - Carseldine Village Stage V (future Village Heart precinct) on Facebook Share Community notice: Development Application lodged - Carseldine Village Stage V (future Village Heart precinct) on Twitter Share Community notice: Development Application lodged - Carseldine Village Stage V (future Village Heart precinct) on Linkedin Email Community notice: Development Application lodged - Carseldine Village Stage V (future Village Heart precinct) linkWe wish to notify you that the Stage V Development Application was properly made on 2 September 2022. This new Development Application proposes three lots for future development, one public plaza lot, one lot for drainage infrastructure and a new road. Collectively these lots form the future Village Heart precinct.
Details of the Development Application can be found here: DEV2022/1321
-
Public notification of two applications for PDA Development Approvals - extended submission period
Share Public notification of two applications for PDA Development Approvals - extended submission period on Facebook Share Public notification of two applications for PDA Development Approvals - extended submission period on Twitter Share Public notification of two applications for PDA Development Approvals - extended submission period on Linkedin Email Public notification of two applications for PDA Development Approvals - extended submission period linkInterested parties are invited to lodge a formal written submission providing feedback on the:
- Request for a Change to the PDA Development Approval for the Carseldine Village Masterplan, which also included a Development Permit for Reconfiguration of a Lot (DEV2018/932), and/or
- PDA Development Permit for Reconfiguring a Lot (Stage 4B of Carseldine Village – 25 residential terrace lots and new road) and Material Change of Use (Plan of Development for Dwelling House and Home-Based Business) (DEV2022/1285).
You can view the applications here by searching DEV2018/932 and DEV2022/1285, or search ‘Carseldine’.
The original closing date for submissions was 5.00 pm on Friday 17th June 2022. This has been extended to 5:00 pm on Thursday 30th June 2022.
How to get involved:
You can lodge a formal submission via:
- On this website: using the lodge a submission tool, or
- Email: pdadevelopmentassessment@dsdmip.qld.gov.au, or
- Post: Economic Development Queensland, GPO Box 2202 Brisbane QLD 4001
-
Public notification of draft DCOP
Share Public notification of draft DCOP on Facebook Share Public notification of draft DCOP on Twitter Share Public notification of draft DCOP on Linkedin Email Public notification of draft DCOP linkA draft Development Charges and Offset Plan (DCOP) has been prepared for the Fitzgibbon Priority Development Area (PDA).
The draft DCOP identifies relevant development charges, how these charges are calculated, levied and administered, and the trunk infrastructure required to service the PDA.
All interested parties and stakeholders are invited to view the draft DCOP and provide feedback during the 20 business day submission period from Monday 9 May until 5:00 pm on Friday 3 June 2022.
You can lodge a formal submission via:
- Online: using the lodge a submission tool
- Email: EDQtechnicalservices@dsdilgp.qld.gov.au
- Post: Economic Development Queensland, GPO Box 2202 Brisbane QLD 4001
Project Timeline
-
July 2008
Carseldine Village has finished this stageFitzgibbon Priority Development Area (PDA) declared, identifying the Carseldine Urban Village site for renewal. Community consultation begins as the Development Scheme is prepared.
-
July 2009
Carseldine Village has finished this stageFitzgibbon PDA development scheme adopted. It is identified that further planning work around the Carseldine Urban Village needed to be undertaken
-
2010 - 2011
Carseldine Village has finished this stageFurther, extensive community engagement undertaken around Carseldine Urban Village site, including the establishment of the Carseldine Community Liaison Group, community newsletters, community information sessions, and a public notification period.
-
July 2011
Carseldine Village has finished this stageAmendments (based on community engagement) to the Fitzgibbon PDA Development Scheme adopted.
-
October 2016
Carseldine Village has finished this stageThe Queensland Government launched the Advancing our cities and regions strategy, which will see surplus and underutilised state property renewed and repurposed. Under this strategy the Carseldine Urban Village is identified as the first SEQ urban renewal precinct to be revitalised.
-
December 2016
Carseldine Village has finished this stageEconomic Development Queensland invited the community to register for community consultation opportunities around the urban village's public realm (to be undertaken in February 2017).
December newsletter with project information was sent to Carseldine, Aspley and Fitzgibbon residents.
Community members could come and talk to Economic Development Queensland at Carseldine Markets on Saturday 3, 10 or 17 December and register for February's community consultation.
Two quick polls were run to tell us what day and time were most suitable for future community consultation.
-
January 2017
Carseldine Village has finished this stageJanuary newsletter with project information was sent to Carseldine, Aspley and Fitzgibbon residents and also is available to download online.
-
February 2017
Carseldine Village has finished this stageEconomic Development Queensland undertook four community engagement workshops in February on place making and community development opportunities within the Carseldine Urban Village. This will build on the existing land use plan to identify a vision for a viable, socially inclusive and sustainable development, now and in the future.
-
April 2017
Carseldine Village has finished this stageApril newsletter on proposed Sport and Recreation precinct is available for download.
-
May 2017
Carseldine Village has finished this stageCommunity engagement session on proposed Sport and Recreation precinct - Sunday 21 May.
Community newsletter No #4 summarising engagement outcomes to-date.
-
June 2017
Carseldine Village has finished this stageRegister for the master plan information sessions
- Sunday 18 June 9 am - 12 pm
- Sunday 18 June 1 - 4 pm
- Thursday 22 June 6.30 - 8.30 pm
-
July - August 2017
Carseldine Village has finished this stageStage S (sport and recreation) development application (DA) lodgement.
-
29 Oct - December 2017
Carseldine Village has finished this stageQueensland Government caretaker period, election and post election departmental changes.
-
May 2018
Carseldine Village has finished this stageApproval of stage S (sport and recreation).
Stage 1 development application (DA) lodgement.
-
mid-2018
Carseldine Village has finished this stageInformation sessions:
- Thursday 21 June 2018
- Saturday 23 June 2018
30 business day public notification period -
August 2018
Carseldine Village has finished this stagePublic notification of the master plan and Stage 1 development application – commences 9 August, concludes 20 September.
-
September 2018
Carseldine Village has finished this stagePublic notification concludes.
Stage S construction commencing. -
October 2018
Carseldine Village has finished this stageStage S construction commences and due for completion mid 2019. -
End 2018
Carseldine Village has finished this stageMaster plan development application approved.
-
October 2019
Carseldine Village has finished this stageAmendment to the overall masterplan and Stage 1 development applications lodged.
-
November / December 2019
Carseldine Village has finished this stageAmendment to the overall masterplan and Stage 1 development applications are publicly notified for a 22 business day period from 20 November to 19 December 2019, giving the community a formal process to have their say on the applications.
-
End 2019
Carseldine Village has finished this stageStage S complete.
-
January 2020
Carseldine Village has finished this stagePedestrian / cycle bridge construction works commenced.
-
February 2020
Carseldine Village has finished this stageThe brand new $6.5m sport and recreation precinct community day on 1 February – everyone is welcome. Further event details are available on carseldinevillage.com.au
-
February 2020
Carseldine Village has finished this stageSales and Information Centre opens. Visit carseldinevillage.com.au for opening hours.
-
April 2020
Carseldine Village has finished this stageStage 1 civil works commenced 27 April.
-
September 2020
Carseldine Village has finished this stageDevelopment Approval received for Stage 2.
-
October 2020
Carseldine Village has finished this stageCabbage Tree Creek pedestrian and cycle bridge opens.
-
Late 2020
Carseldine Village has finished this stageSuccessful developer for the aged care site announced – Rockpool Residential Aged Care.
-
Late 2020
Carseldine Village has finished this stageStage 2 civil and electrical work commenced.
-
May 2021
Carseldine Village has finished this stageStage 1 construction works complete.
-
May 2021
Carseldine Village has finished this stageNew entry road into Carseldine Village – called Plaza Place opened.
-
May 2021
Carseldine Village has finished this stageRockpool Residential Aged Care commenced construction.
-
August 2021
Carseldine Village has finished this stageCabbage Tree Creek bushland vegetation works are anticipated to be completed.
-
September 2021
Carseldine Village has finished this stageStage 2 civil and electrical works completed.
-
October 2021
Carseldine Village has finished this stageVillage Heart ROI was released.
-
October 2021
Carseldine Village has finished this stageStage 3 civil and electrical works commenced.
-
Early 2022
Carseldine Village has finished this stageStage 1 home owners start moving into their new terrace homes.
-
July 2022
Carseldine Village has finished this stageRockpool Residential Aged Care opens
-
July 2022
Carseldine Village has finished this stage4A House & Land Packages released
-
July 2022
Carseldine Village has finished this stageStage 2 Homes commence construction
-
August 2022
Carseldine Village has finished this stageStage 3A & 4A civil & electrical works completed
-
August 2022
Carseldine Village has finished this stageNew C&K Childcare Centre commences construction, completion due mid-2023
-
August 2022
Carseldine Village has finished this stage4B House & land packages released
-
March 2023
Carseldine Village has finished this stageStage 3 homes commence construction
-
March 2023
Carseldine Village has finished this stageStage 4B civil, electrical and landscaping works commence
-
July 2023
Carseldine Village has finished this stageBrand new C&K Childcare opens at Carseldine Village
-
August 2023
Carseldine Village has finished this stageStage V civil, electrical and landscaping works commence.
-
September 2023
Carseldine Village has finished this stageStage 4B civil and electrical works complete.
-
mid 2024
Carseldine Village is currently at this stageStage V works likely to be completed, subject to weather and/or industry delays
Notices
-
Carseldine Village - BMD Community Notice 1-19 September 2022.pdf (251 KB) (pdf)
-
Carseldine Village - Temporary Road Closure - Plaza Pl Carseldine (1.18 MB) (pdf)
-
Community Notice - Survey and Investigation Works - Beams Road.pdf (78.3 KB) (pdf)
-
Community Notice - Stage 4B and Catch Drain Works - Carseldine Village.pdf (520 KB) (pdf)
-
Community Notice - Stage V works - Carseldine Village.pdf (303 KB) (pdf)
Historical document library
-
CUV Newsletters and Fact sheets
-
Carseldine Urban Village newsletter May 2018 (1.62 MB) (PDF)
-
Carseldine Urban Village fact sheet Feb 2018 (1.01 MB) (pdf)
-
Carseldine Urban Village Newsletter Aug 2017 (1.83 MB) (pdf)
-
Carseldine Urban Village Newsletter May 2017 (1.27 MB) (pdf)
-
Carseldine Urban Village newsletter April 2017 (909 KB) (pdf)
-
Carseldine Urban Village newsletter Jan 2017 (742 KB) (pdf)
-
Carseldine Urban Village newsletter Dec 2016 (7.71 MB) (pdf)
-
-
Community engagement information boards and reports
